Catfish Creek Sanitary Sewer Improvements
The City of Dubuque is upgrading the Catfish Creek Sanitary Sewer system and lift station to improve performance, reduce the risk of sewer overflows, and support future development. These improvements will ensure our wastewater infrastructure continues to serve residents reliably for decades to come.
This project has been carefully planned over many years to meet the needs of our growing community. The timeline of key milestones highlights major steps in the planning, design, and construction process.
Late 1960s
Original Sewer System Built
- The Catfish Creek Sanitary Sewer (CCSS) was built to carry wastewater to the Catfish Creek Lift Station (CCLS).
- These pipes are still working today, which is normal. Sewer pipes can last 60 years or more.
- However, when cities build interceptor sewers (the large pipes that carry wastewater from smaller pipes to a lift station or treatment plant), they usually design them to handle expected growth for the next 25 to 50 years.
1995
Lift Station Upgraded
- The CCLS was upgraded to handle 8 million gallons per day (MGD).
- This upgrade was based on expected growth over the next 20–30 years.
2000–2020
Growth in the Area
- Despite challenges due to terrain (steep slopes, bluffs, shallow rock, etc.), the City experienced significant growth within the Catfish Creek Sewershed in the last 20 years.
- Since the lift station was last upgraded in 1995 to a capacity of 8 MGD, the system’s flow increased by 6.5 MGD.
Late 2018
System Study Begins
- The City hired Strand Associates, Inc. to study the sewer system’s capacity.
- Flow meters and computer models were used to understand how the system performs during wet weather.
- The study found that during heavy rain, parts of the system become pressurized, raising the risk of sanitary sewer overflows (SSOs).
December 2020
Study Results Shared
- Strand delivered:
- A full report on the sewer system.
- A technical memo on how new industrial development could affect the system.
January 4, 2021
Funding Application Submitted
- The City applied for a $350,000 Planning & Design Loan through the State Revolving Fund (SRF) for the Catfish Creek Lift Station & Force Main Project.
- The project included system improvements to address wet-weather related overflows and provide capacity for future development within the Catfish Creek sewershed.
April 28, 2021
Initial Design Work Begins
- The City approved a contract with Strand to:
- Create a 30% design for a new lift station on Old Mill Road.
- This design level provided the cost estimates and design details needed for the City to submit a facility plan to the Iowa Department of Natural Resources (Iowa DNR) to begin the SRF construction loan process.
May 2021
Facility Plan Submitted
- The City submitted a facility plan to the Iowa DNR.
- The plan included:
- Construction of a new 20 MGD lift station.
- 30-inch dual force mains to carry wastewater to the treatment plant.
June 7, 2021
City Council Approval
- The Dubuque City Council approved the facility plan and SRF application for the Old Mill Rd. Lift Station and Force Main Project.
February 2022
Final Design Agreement
- Through the RFP process, Strand Associates, Inc. was selected.
- The City signed a contract with Strand to:
- Finalize the design of the lift station and force mains
- Assist City staff with bidding services and railroad permitting for horizontal bores under the railroad tracks
- City staff handled:
- Site and utility design for the remainder of the project
- Coordination with IDNR and property acquisitions
2022–2023
Environmental & Historical Review
- As part of the SRF process, the project underwent an environmental review.
- The Office of the State Archaeologist (OSA) conducted a phase I archaeological study due to a portion of the project alignment running through the old Town of Rockdale. Some artifacts from the settlement were recovered, and it was determined that a more in-depth phase II study was warranted.
- Due to the results of the phase II study, it was determined that an alternate alignment needed to be evaluated to avoid the Town of Rockdale.
- A second route was chosen to avoid the area, and the new alignment was approved by the State Historic Preservation Office (SHPO).
- With the alignment approved, the design could then be completed for the entire project.
May 2024
Project Phased Due to Funding
- Due to available funding and the funding being spread over five fiscal years, a revised facility plan was submitted to the IDNR, which split the project into two phases.
- Phase 1: Build the lift station and prepare the site.
- Phase 2: Install the force mains and related structures from the lift station to the Water Resource and Recovery Center (WRRC)
June 2024
Revised Plan Approved
- The Iowa DNR approved the revised (two-phase) facility plan.
- Phase 2 will begin when funding becomes available in FY26 and FY27.
- Phase 2 will be completed before Phase 1 is finished.

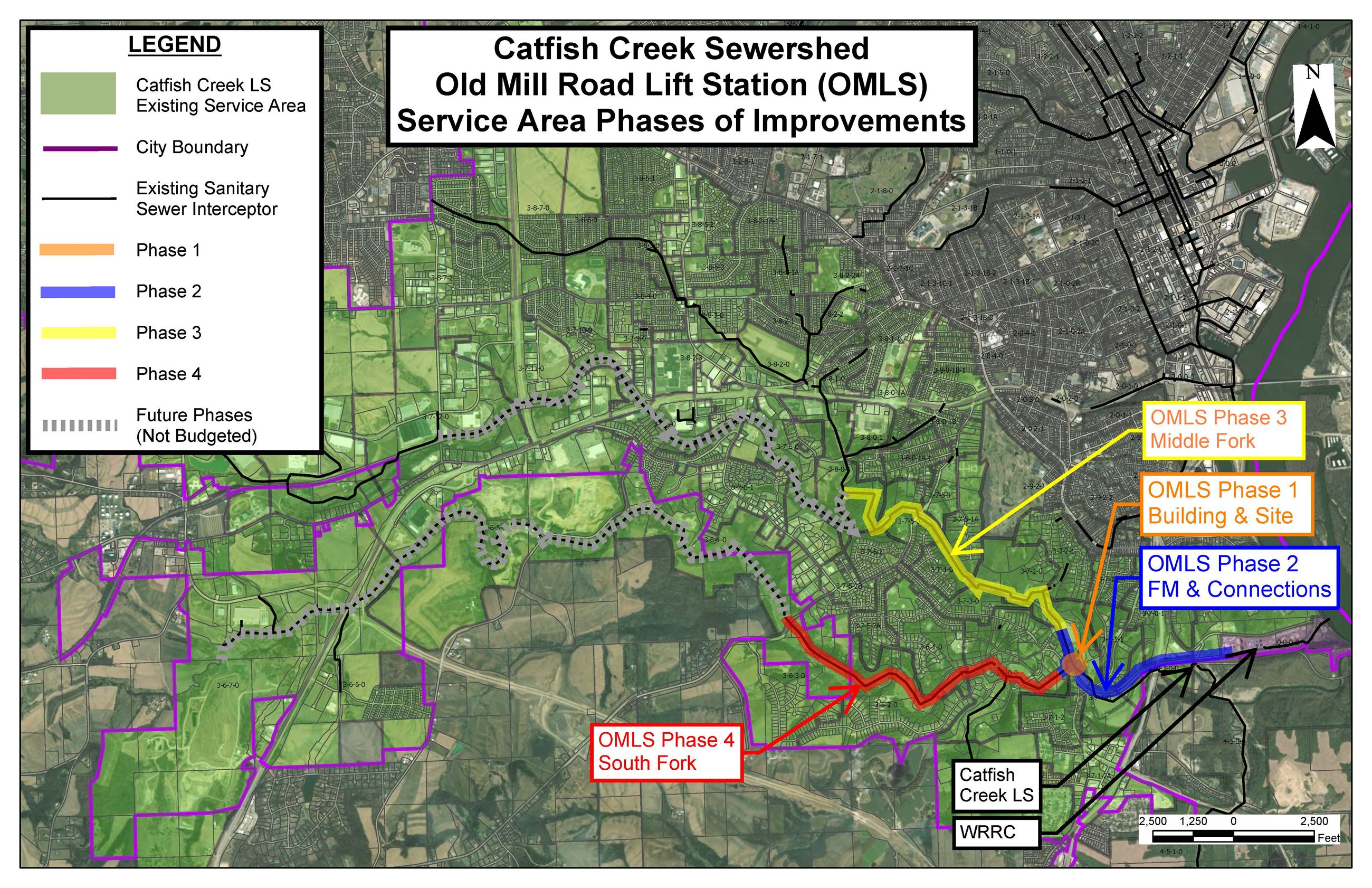

Old Mill Rd. Lift Station and Force Main Project
November 2024 - December 2026
The Old Mill Road Lift Station and Force Main Project is the first in a series of planned improvements to the Catfish Creek Interceptor Sewer system. These upgrades are necessary to ensure the system can handle current wastewater flows and support future development as the City continues to grow.
Once completed, the new 20 million gallons per day (MGD) lift station will take on more than 80% of the flow that currently goes to the existing 8 MGD Catfish Creek Lift Station. This shift will allow the Catfish Creek Lift Station to primarily serve the Key West area and future growth along U.S. Highway 151/61, including areas near the airport that are connected to the Granger Creek Interceptor Sewer.
Since 2017, the Iowa Department of Natural Resources (IDNR) has issued sanitary sewer permits for developments south of the city with peak flows totaling approximately 3.5 MGD. By redirecting flow from the west side of town, the Catfish Creek Lift Station will have the capacity it needs to continue serving the southern sewershed effectively in the years ahead.
Old Mill Rd. Lift Station
Phase 1 includes the design, permitting, easement acquisition, and construction services for the Old Mill Rd. Lift Station building and site improvements.
City Contact Information:
- Todd Irwin
Water Resources Project Supervisor
Email Todd | 563-599-2041
Consultant: Strand Associates, Inc.
Contractor: Tricon Construction Group
Estimated Schedule:
- Design Start: March 2022
- Design Complete: August 2024
- Construction Start: November 2024
- Construction Complete: December 2026
Force Mains and Related Structures
Phase two includes the design, permitting, easement acquisition, and construction services for the force mains and gravity sewer that will connect the new Old Mill Rd. Lift Station building to the upstream gravity sewer and the downstream Water & Resource Recovery Center (WRRC) wastewater treatment plant.
City Contact Information:
- Todd Irwin
Water Resources Project Supervisor
Email Todd | 563-599-2041
Consultant: Strand Associates, Inc.
Contractor: Top Grade Excavating
Estimated Schedule:
- Design Start: April 2024
- Design Complete: April 2025
- Construction Start: September 2025
- Construction Complete: December 2026
Future Phases & Improvements
January 2027 - December 2028
Middle Fork Interceptor from Old Mill Rd. to Brunskill Rd.
Phase 3 of the Catfish Creek Sanitary Sewer improvements includes targeted upgrades to the Middle Fork interceptor. This phase will upsize approximately 2 miles of the 9.9-mile interceptor, specifically from Old Mill Rd. to Brunskill Rd.
Phase 3 of the project includes:
- Engineering design
- Permitting
- Easement acquisition
- Construction services
City Contact Information:
- Max O’Brien
Civil Engineer
Email Max | 563-594-8666
Consultant: HDR Engineering
Estimated Schedule:
- Design Start: September 2025
- Design Complete: October 2026
- Construction Start: January 2027
- Construction Complete: December 2028
South Fork Interceptor from Old Mill Rd. to N. Cascade Rd.
Phase 4 of the Catfish Creek Sanitary Sewer improvements includes targeted upgrades to the South Fork Interceptor. This phase will upsize approximately 2 miles of the 6.9-mile interceptor, specifically from Old Mill Rd. to N. Cascade Rd.
The project scope includes:
- Engineering design
- Permitting
- Easement acquisition
- Construction services
City Contact Information:
- Todd Irwin
Water Resources Project Supervisor
Email Todd | 563-599-2041
Consultant: Foth Infrastructure & Environment
Estimated Schedule:
- Design Start: September 2025
- Design Complete: October 2026
- Construction Start: January 2027
- Construction Complete: December 2028
